Soilbuild Construction Maintains Strength Despite Project Delays August 28, 2026

Brief Overview

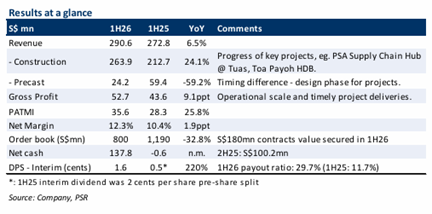

Soilbuild Construction Group Ltd delivered mixed 1H26 results with revenue and profit below expectations, primarily due to significant delays in precast project recognition. However, the company demonstrated resilience with 25.8% year-on-year profit growth driven by strong construction segment performance and margin expansion, whilst maintaining its dividend appeal through increased payout ratios.
Investment Positives
The standout positive for TeleChoice centres on the strong momentum in its PCS division. PCS revenue grew an impressive 25% year-on-year in 1H26 to S$205mn, whilst profit before tax spiked 140% to S$6.1mn. This growth was driven by U Mobile’s expansion in mobile subscribers, with handset demand receiving additional support from promotional activities and increased subsidies as more consumers transition from prepaid to postpaid plans.
Margin performance proved particularly impressive, with 1H26 net margins expanding by 1.9 percentage points year-on-year to 12.3%. This represents an 8.2 percentage point premium over average local peers’ net margins of 4.1%, achieved through operational scale benefits and timely project deliveries.
The company’s balance sheet strength improved markedly, with 1H26 net cash turning positive to S$138 million compared to 1H25 net debt of S$0.6 million. This transformation was driven by 18% year-on-year higher operating cash flow to S$56.5 million, whilst receivables fell S$30.7 million half-on-half, freeing up working capital.
Shareholder returns increased substantially through a higher dividend payout ratio. The proposed interim dividend of 1.6 cents per share represents a 2.2 times year-on-year increase from 0.5 cents per share in 1H25. The 1H26 dividend payout ratio increased by 18 percentage points year-on-year, supported by the stronger balance sheet.
Investment Negatives
Precast segment performance presented challenges, with revenue declining 59% to S$24.2 million due to project recognition delays. Many precast projects remained in the design phase, creating timing differences that impacted overall revenue achievement.
Order book size decreased to S$800 million from S$1.19 billion in 1H25, representing a 32.8% decline following progress on major projects with exceptional scale, reducing visibility for future performance.
Outlook
Production is expected to ramp up in 2H26 and into 1H27 as precast projects advance beyond the design phase. Higher industrial demand is anticipated as 29% more industrial land is released from the Industrial Government Land Sales programme for 2H26. The company is expected to gradually win more tenders and expand its order book size beyond S$1 billion.
Recommendation & Target Price
Phillip Securities Research maintains a BUY recommendation with an unchanged target price of S$1.20. The valuation multiple was lowered from 9 times to 8.5 times FY27 price-to-earnings ratio to reflect lower visibility from the smaller order book. The company trades at an FY26 dividend yield of approximately 6.2%.
Frequently Asked Questions
Q: What caused Soilbuild's revenue to fall below expectations?
A: The shortfall was mainly due to a 59% decline in precast revenue to S$24.2 million, caused by delays in project recognition as many precast projects were in the design phase.
Q: How did the company achieve profit growth despite revenue challenges?
A: PATMI increased 25.8% year-on-year to S$35.6 million, driven by a 24% year-on-year increase in construction revenue from key projects like PSA Supply Chain Hub @ Tuas and Loyang Way projects.
Q: What is Soilbuild's competitive advantage in margins?
A: The company's 1H26 net margins of 12.3% are 8.2 percentage points higher than average local peers' net margins of 4.1%, achieved through operational scale and timely project deliveries.
Q: How has the company's financial position improved?
A: Net cash turned positive to S$138 million compared to 1H25 net debt of S$0.6 million, driven by 18% year-on-year higher operating cash flow and reduced receivables.
Q: What is the outlook for industrial demand?
A: Higher industrial demand is expected as 29% more industrial land is released from the Industrial Government Land Sales programme for 2H26.
Q: What dividend yield does Soilbuild offer?
A: The company trades at an FY26 dividend yield of approximately 6.2%, with the interim dividend payout ratio increased by 18 percentage points year-on-year to 30%.
Q: When is precast revenue expected to recover?
A: Production is expected to ramp up in 2H26 and into 1H27 as projects advance beyond the design phase.

This article has been auto-generated using PhillipGPT. It is based on a report by a Phillip Securities Research analyst.
